It was found, as expected, that the change in resolution had a
substantial impact on the quality of the ensemble forecasts. The rms error

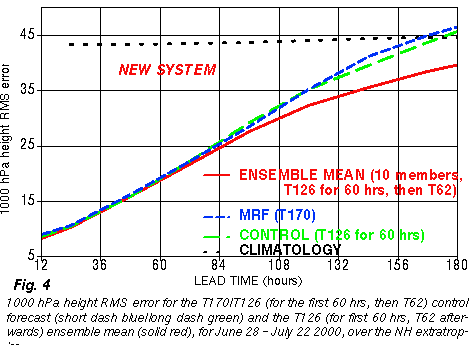

of the ensemble control and mean forecasts is reduced (Figs.
3 and 4).As
a result, the ensemble mean forecast now has scores that is equal to or
better than those for the T170 high resolution MRF control forecast at
all lead times. The gap between the ensemble mean error and ensemble spread,
which should ideally be equal, is also reduced (Fig.
5).
Moreover, the
cloud of ensemble forecasts misses the verification only 6% of the time,
compared to a 14% excessive missing rate (above that expected due to the
finite size of the ensemble) at 60 hrs lead time (Fig.
6).
In addition, the
T170 high resolution control MRF forecast is the best member of the 23-member
ensemble only 5.1% of the time, only 19% more often than expected if all
members were equally likely (which correspondes to a 4.3% best verification

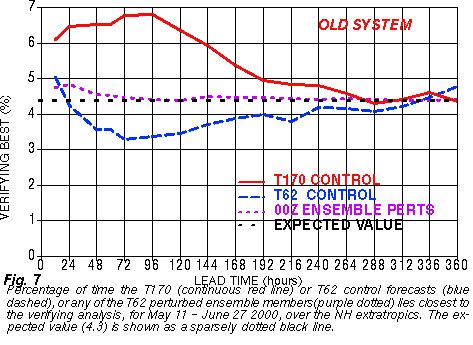

score, Fig. 7).

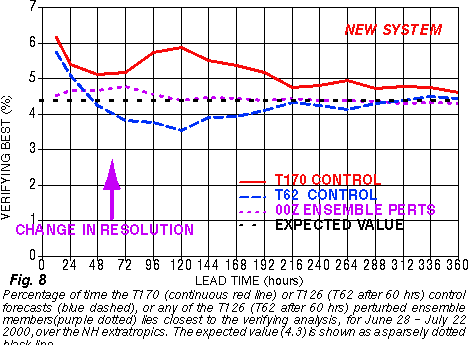

This is to be compared to 6.5% rate before the ensemble resolution increase,
which is 51% above the 4.3% expected best verification rate (Fig.
8).
With the implemented changes the ensemble forecasts provide improved
forecast guidance twice a day. Regarding the possibility of the combined
use of the latest set of ensemble forecasts and the 12-hour older set of

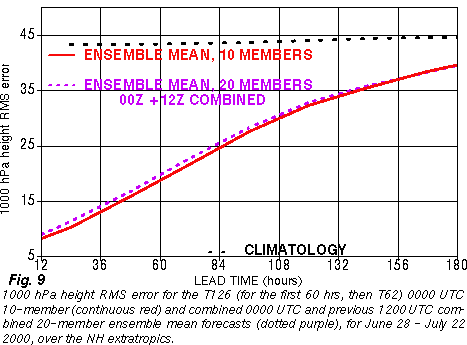

ensemble, ensemble mean pattern anomaly correlation, rms (Fig.
9), and probabilistic
verification scores (Fig. 10)
indicate
that the inclusion of the 12-hour older members degrades the quality of
the ensemble until 132-168 hours lead time is reached. Apparently the disadvantages
resulting from the inclusion of less skilful older members outweighs the
advantages of having more members until 6-7 days lead time or so. Therefore
it is recommended that for the first week only the latest set of ensemble
members are used in forecast applications.
